Caisson Seawalls

Seawater Construction

Upper levels of caissons may be cast while completed lower levels are submerged in sea water, with the sea water curing the concrete of the lower levels. This is useful if land infrastructure is not available for constructing entire caissons on land.

For example, if a semi-submersible barge is not available to transport completed caissons, partially completed caissons can be sumberged on the sea bed for completion of upper levels of the caisson above the water.

When doing this, the sea water must be deep enough to allow flotation after constructing the caisson level that is above the water. This process is repeated at different water depths as additional caisson levels are constructed.

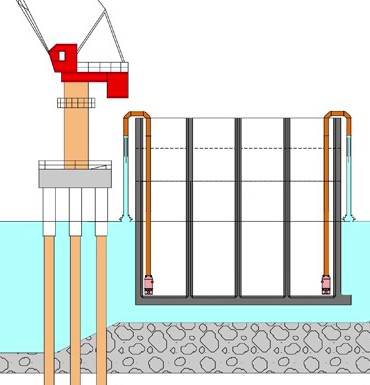

Figure 1:  Seabed for partially submerging caissons during caisson construction, Kashima, Japan. A crane is installed on posts to facilitate caisson construction. A partially constructed caisson is floated to the seabed that is 9 meters deep. [MLIT]

Figure 2:  Water pumps hanging in the sea have pumped sea water into the caisson, causing the caisson to sink to the seabed. The caisson is taller than the seabed is deep. The upper portion of the caisson is above the sea water surface. [MLIT]

Figure 3:  Construction of the caisson has proceeded. Two new levels have been added to the top of the caisson. [MLIT]

Figure 4:  Water is pumped out of the caisson, causing it to float. [MLIT]

Figure 5:  The caisson is floated to the deeper seabed. [MLIT]

Figure 6:  Water is pumped into the caisson to make it sink. The bottom of the caisson rests on the seabed. The top of the caisson is above the water surface, where additional levels of the caisson will be constructed. [MLIT]

Figure 7:  Two caissons under construction. The caisson on the right is resting on seabed that is 9 meters deep. The caisson on left is in 12 m deep water. [MLIT]

Figure 8:  Tying rebar (reinforcing bars) on the new level of a caisson. At right is another caisson under construction. [MLIT]

Figure 9:  Rebar is tied. Forms are placed. Work flooring is moved to top of forms. [MLIT]

Figure 10:  Concrete is poured. [MLIT]

Video

Short video: Tying rebar. [MLIT]
